Turn-Key Cold Storage Project
Turn-Key Cold Storage Project
2018
14 Nov
Start
Our customer sent requests.
11 Dec
Preparing Project
Our project team prepared the project.
17 Dec
Offer
We sent the offer to our customer.
28 Dec
Confirmation
Our customer approved the offer.
2019
02 Jan
Production
Production started.
04 Feb
Shipment
Shipment started.
26 Feb
Assembly
Assembly started.
23 Aug
Completed
The project completed.

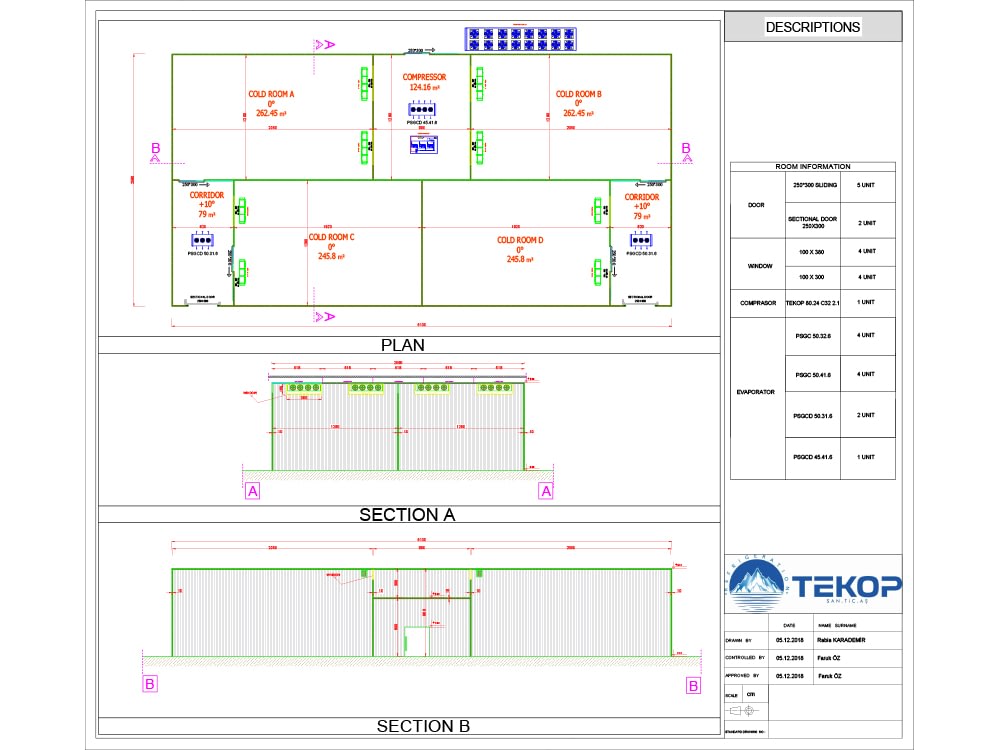

Project Information
ROOM TYPES : | 6 x Cold Rooms |
PROJECT PURPOSE : | General Cold Room |
PROJECT AREA : | 1328 m² |
REFRIGERATION SYSTEMS : | Central Refrigeration System |
DOORS : | 7 x Sliding Cold Storage Doors |
PANELS : | 3500 m² |
Customer Requests
- 2045 m³ capacity 4 pcs. Cold Room (0 °C)
- 658 m³ capacity 2 pcs. Cold Room (+10 °C)
- 1305 m³ capacity 1 pc. Compressor Room
- Central Refrigeration Systems
Project Details
ROOM NAME | WIDTH | LENGTH | HEIGHT | ROOM TEMPERATURE | CAPACITY |
4 x CHILLER ROOM | 19 m | 13 m | 8 m | 0 °C | 2045 m³ |
2 x CHILLER ROOM | 6 m | 13 m | 8 m | +10 °C | 658 m³ |
